commercial solar power



We have helped many businesses save on their bottom line by installing a solar power system. This may be a system size from 10kW to well over 100kW.
Owners of a solar power system over 100kW are considered to be an electricity generator.  Under the Renewable Energy Target, systems over 100kW will under go and accreditation process and produce Large-scale Generation Certificates.

Some businesses we have supported have included those in education, manufacturing, aged care facilities, retail spaces and more.

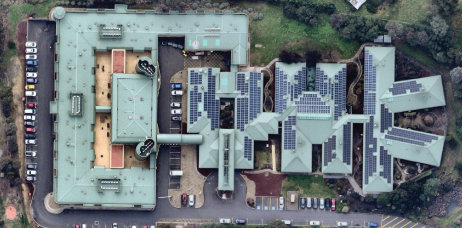

On Luck Chinese Nursing Home

ON LUCK CHINESES NURSING HOME

System Description 254.35kW
Panels 865 Canadian Solar Panels
Inverter 6 SolarEdge Inverters

Installation completed in 2019 to provide cost savings.
Fully monitored by Energy Assist.
The system was designed by Energy Assist and approved by Ausnet Services.
Design and approval timeframe 18 weeks
Installation timeframe 4 weeks

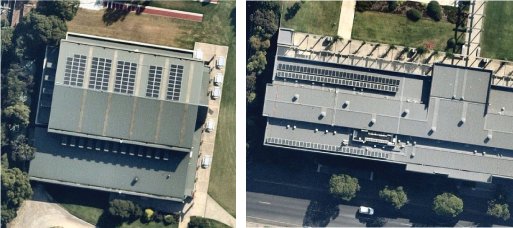

Sacred Heart College

SACRED HEART COLLEGE

System Description 59kW
Panels 207 JA Solar 285W
Inverter 2 SolarEdge 27.6K
Buildings 2

Installation completed in 2017 to provide cost savings.
Fully monitored by Energy Assist.
The system was designed by Energy Assist and approved by Powercor Services.
Design and approval timeframe 18 weeks
Installation timeframe 4 weeks

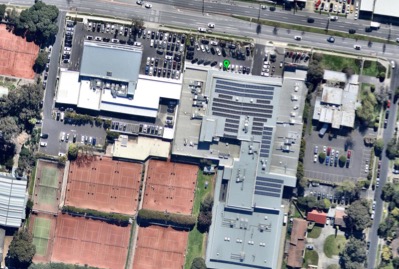

BMW Doncaster

BMW DONCASTER

System Description 94kW
Panels 333 Canadian Solar Tier One
Inverter 3 SMA

Installation completed in 2016 to provide cost savings. Fully monitored by Energy Assist. The system was designed by Energy Assist and approved by United Energy.
Design and approval timeframe 11 weeks
Installation timeframe 6 weeks

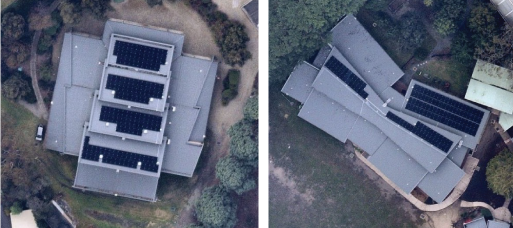

Sacred Heart Primary School

SACRED HEART PRIMARY SCHOOL

System Description 87kW
Panels 272 SunPower 320W
Inverter 2 SolarEdge 33.3K
Buildings 2

Installation completed in 2022 to provide cost savings.
Fully monitored by Energy Assist.
The system was designed by Energy Assist and approved by Ausnet Services.
Design and approval timeframe 18 weeks
Installation timeframe 4 weeks

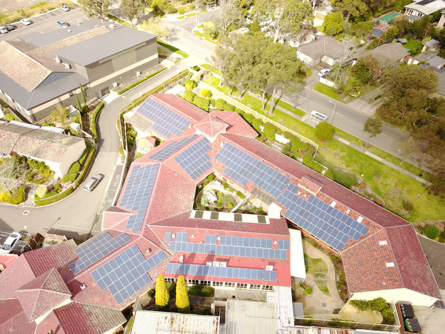

AdventCare

ADVENTCARE Nursing Home

System Description 100kW
Panels 398 Jinko Solar Tier One
Inverter 15 ABB TRI Power
Buildings 7

Installation completed in 2015 to provide cost savings. Fully monitored by Energy Assist. The system was designed by Energy Assist and approved by Ausnet Services.
Design and approval timeframe 9 weeks
Installation timeframe 6 weeks

Contact: – Keith King 9259 2000

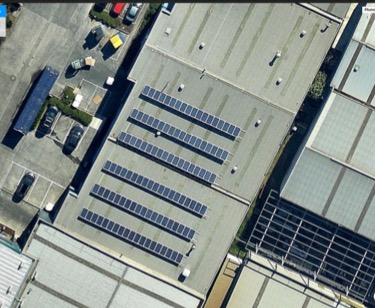

Ravenswood

RAVENSWOOD AUSTRALIA

System Description 29kW
Panels 105 Canadian Solar
Inverter 1 SMA TRI Power

Installation completed in 2017 to provide cost savings. Fully monitored by Energy Assist. The system was designed by Energy Assist and approved by Ausnet Services.
Design and approval timeframe 7 weeks
Installation timeframe 1 week

Edinburgh College

EDINBURGH COLLEGE

System Description 80kW
Panels 320 Jinko Solar Tier one
Inverter 4 ABB TRI Power
Buildings 4

Installation completed in 2016 to provide cost savings. Fully monitored by Energy Assist.
The system was designed by Energy Assist and approved by Ausnet Services.
Design and approval timeframe 10 weeks
Installation timeframe 4 weeks

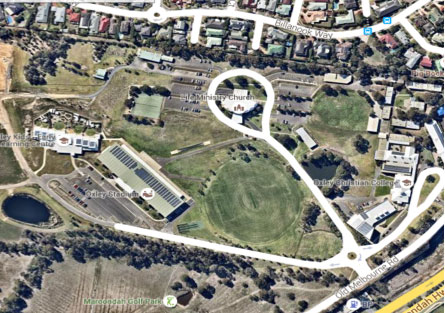

Oxley College

OXLEY COLLEGE

System Description 467kW
Panels 1,868 Trina / Canadian Solar Tier one
Inverter 15 ABB TRI Power
Buildings 7

Installation completed in 2015 to provide cost savings. Fully monitored by Energy Assist. The system was designed by Energy Assist and approved by Ausnet Services.
Design and approval timeframe 16 weeks
Installation timeframe 10 weeks

Contact: – Graham Nelson 0413 279 408

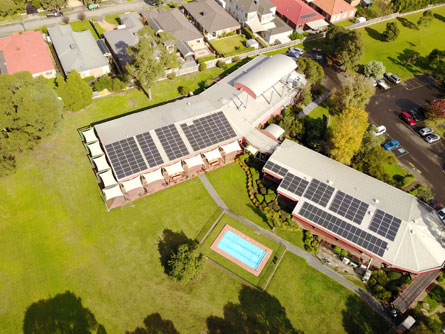

Autodesk

AUTODESK

System Description 80kW
Panels 320 JA Solar Tier one
Inverter 3 SOLAREDGE
Buildings 2

Installation completed in 2017 to provide cost savings. Fully monitored by Energy Assist.
The system was designed by Energy Assist and approved by Ausnet Services.
Design and approval timeframe 18 weeks
Installation timeframe 4 weeks

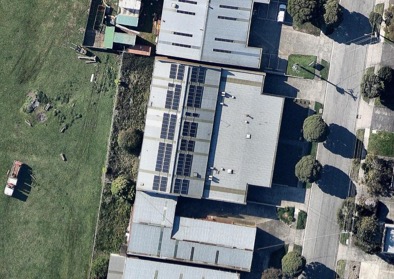

Paramount Aircon

PARAMOUNT AIR-CONDITIONING

System Description 29kW
Panels 109 Canadian Solar Tier One
Inverter 1 SolarEdge

Installation completed in 2016 to provide cost savings. Fully monitored by Energy Assist. The system was designed by Energy Assist and approved by United Energy.
Design and approval timeframe 5 weeks
Installation timeframe 1 week

previous arrow
next arrow

Energy Assist Solar 4 You working with schools and the commuity



get in touch with us
Feel free to contact us if you have any questions
Please enter your name!
Mobile or landline. Please include area code if appropriate
Please enter your email!
Write your message!

Showroom & Testing Facility:

1/35-43 Lacey Street Croydon, VIC 3136

Mornington Office: 7/230 Main Street

Point Lonsdale Office: 7 Kings Court

Address:
03 9725 4484
Phone:
info@solar4you.com.au
E-mail:
